RAF Valley AGL Refurbishment
As part of the AOS Framework, LAML delivered the AGL refurbishment for RAF Valley’s secondary runway.
Client: RAF Valley
Contract Dates: October 2024 - October 2025
As part of the AOS Framework, LAML delivered the AGL refurbishment for RAF Valley’s secondary runway, supporting Lagan Aviation & Infrastructure.
Works included:
Upgrading all runway, taxiway and approach lighting to LED,
Installing over 700 transformers,
New CCR, MCS and termination panels delivering all associated M&E within the new substation.
The project also included a CL2B approach system, replacement of wing bars and IRDMs, and an MCS upgrade to support the modernised AGL infrastructure.

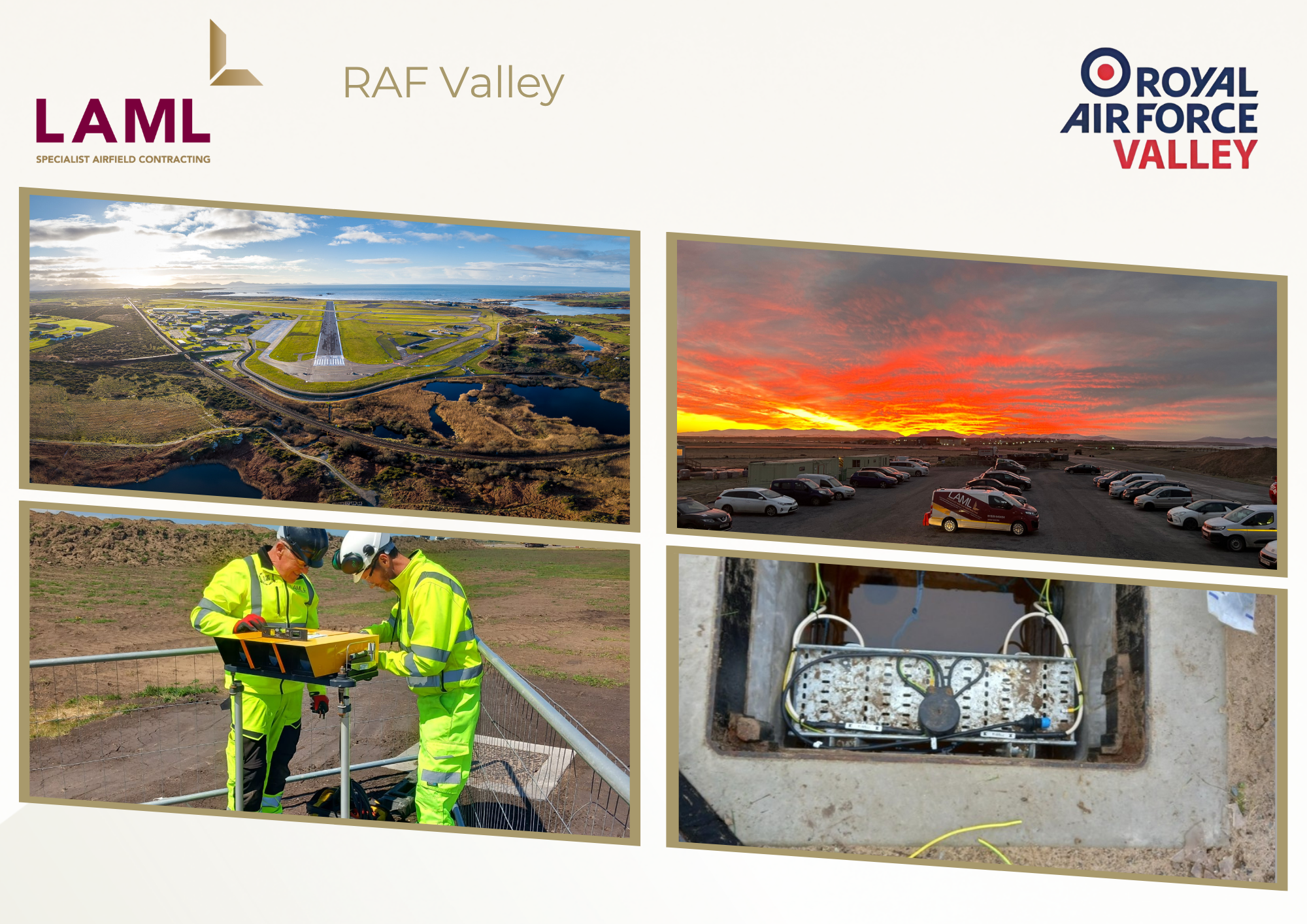

Summary of activities:
M&E Fit Out B2a & B2b New Lighting Protection System to B2a & B2b -2nr Installation of CCRs
New AGL Cable Termination Panels
AGL LED Lighting Upgrade& Airfield Signage Installation of IRDMs
MCS Modifications & upgrade & new TL48s & D20s
Installation of AGL 6mm Earthing - 32,500m Static Earthing Installation to ASP1 -1nr
Installation of new Seating Pots – 401nr
Replacement of 019 Approach Masts
Installation of new Primary Cabling – 55,000m
Installation of new 2core 4mm Secondary Cabling -16,000m
Photometric Testing 19/01
Runway Flight Calibration Check
